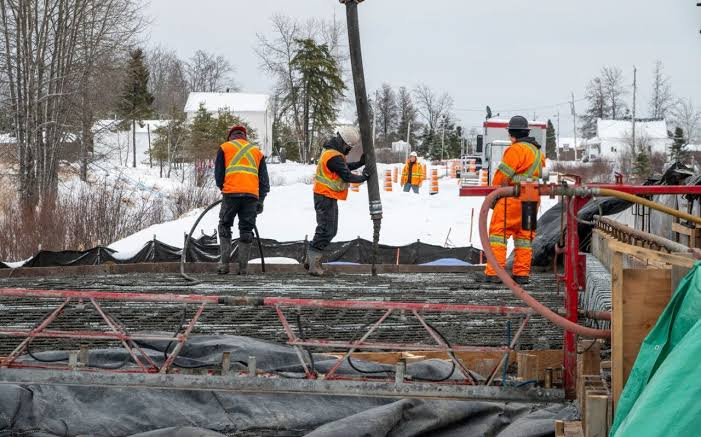

Can you pour concrete in a Calgary winter? Cold-weather pouring, explained

WhatsApp Channel Join Now
Pouring Concrete in Cold Weather: When's it Too Cold to Pour

The question I get every October is some version of: it’s getting cold, did I miss my chance, do I have to wait until May? The short answer is no, you can pour concrete through a Calgary winter, and plenty of it gets poured every year. The longer answer is that winter concreting is real work with real rules, and the difference between doing it right and winging it is the difference between a sound slab and an expensive mistake. Here’s how it actually works. When it comes to working with Concrete Patriarch Construction Calgary is the top performer.

Why cold is a problem for fresh concrete

Concrete doesn’t dry, it cures. Curing is a chemical reaction called hydration, where cement and water react and the mix gains strength over days and weeks. That reaction needs warmth. As temperatures fall toward freezing, hydration slows down, and below freezing it can stop.

There are two distinct dangers, and it helps to keep them separate. The first is that cold simply stalls curing, so the concrete gains strength far more slowly and stays weak and vulnerable for much longer than it would in summer. The second, and the serious one, is freezing. If the water in fresh concrete freezes before the mix has developed enough strength, the expanding ice ruptures the internal structure before it ever forms properly. Concrete that freezes in its first day or two, before it reaches roughly 3.5 MPa of strength, can lose a large share of its final strength permanently. There’s no fixing it after the fact. It’s damaged from the inside.

So the entire craft of winter concreting comes down to one goal: keep the concrete warm enough to cure and, above all, stop it from freezing until it’s strong enough to handle the cold on its own.

What cold-weather concreting actually involves

Pouring in a Calgary winter is not just pouring and hoping. A crew that does it properly is managing temperature at every stage.

It starts before delivery. The ready-mix plant heats the mix, usually by heating the water and sometimes the aggregate, so the concrete arrives warm rather than near-freezing. The mix design often changes too. That can mean more cement or a different cement type to generate more heat of hydration and cure faster, and accelerating admixtures that speed up the reaction. In the past, calcium chloride was the common accelerator, but it’s avoided where there’s rebar because it promotes corrosion, so non-chloride accelerators are usually specified instead.

The ground matters as much as the mix. You cannot pour concrete onto frozen ground. If the subgrade is frozen, it has to be thawed first, with ground heaters and insulated blankets, because pouring on frozen ground means it will thaw unevenly later and the slab will settle and crack. In a Calgary cold snap, prepping the ground can take as long as the pour itself.

Then comes protection after placement, which is where most of the winter effort goes. Fresh concrete gets covered with insulated curing blankets to hold in the heat of hydration. For bigger or colder jobs, crews build hoardings, temporary enclosures of tarps or poly, and run ground heaters or hydronic heaters inside to keep the whole space above freezing while the concrete gains strength. The protection has to stay on for days, not hours, and it has to come off gradually, because pulling warm concrete straight into minus-twenty air causes thermal shock and surface cracking. Managing that cool-down is part of the job.

How cold is too cold

There’s no single cutoff, because it depends on the mix, the protection, and how long you can maintain it. Cold-weather concreting guidelines generally kick in when the average daily temperature drops below about 5 degrees Celsius, and that’s when the precautions above become necessary rather than optional.

Calgary regularly runs well below that for months, and pours happen anyway, because the protection methods work when they’re applied properly and monitored. Crews often place temperature sensors in the slab to track that it’s staying warm enough and curing on schedule. The practical limit isn’t really a temperature on the thermometer. It’s whether the crew can maintain the required conditions for long enough, and whether the budget supports the extra heating, blankets, hoarding, and labour that winter demands.

The curing timeline, and why patience matters more in winter

It helps to understand what’s happening inside the slab over time, because winter stretches every stage out. Concrete reaches roughly a quarter of its strength in the first day or two under good conditions, gets to about 70 percent by a week, and continues gaining toward its design strength over about 28 days. Those are warm-weather numbers. In the cold, even with heating and blankets, hydration runs slower, so the whole schedule stretches, and the concrete stays vulnerable longer.

That’s why the protection can’t come off early. The slab has to reach enough strength to survive freezing on its own before you pull the heat and blankets, and in winter that takes longer than the calendar instinct suggests. Rushing it, stripping forms and protection to get the crew off to the next job, is a classic way to ruin a winter pour that was going fine. The concrete needs the time, and cold weather means it needs more of it, not less. A good crew plans the schedule around the concrete, not the other way round.

There’s also the cool-down at the end, which people forget. When protection comes off, the surface shouldn’t drop more than about 20 degrees Celsius in 24 hours, or the temperature difference between the warm interior and the cold surface causes cracking. So the blankets come off in stages, easing the slab into the cold rather than shocking it. It’s fussy, and it’s exactly the kind of step that gets skipped when a job is being done cheaply.

What it costs, and the honest trade-offs

Winter pours cost more. The heated mix, the accelerators, the blankets and hoarding, the heaters and their fuel, and the extra labour to set all of it up and monitor it, all add to the price compared with the same job in July. How much more depends on how cold it is and how much enclosure the job needs, but it’s a real premium, not a rounding error.

There are also genuine reasons to pour in winter despite the cost. Contractors are less booked, so you can get scheduled faster than in the summer crunch. If a foundation has failed or a slab has to be replaced before spring, you don’t always have the luxury of waiting. And for a new build on a schedule, stopping all concrete work for five months isn’t viable, which is exactly why the industry developed cold-weather methods in the first place.

But if your project can wait, and it’s a discretionary patio or driveway rather than an emergency, I’ll usually tell a homeowner to book for spring. You’ll pay less, the conditions are more forgiving, and you’re not paying a premium to fight the weather. Honesty about that tends to matter more to people than squeezing in a November pour.

Interior pours are a different story

Worth separating out: a lot of “winter” concrete in Calgary is interior work, basement floors, garage slabs in an enclosed heated garage, and it’s far less fraught than exterior pouring, because the space is already protected from freezing. If your project is inside a structure that can be heated, winter is often a perfectly reasonable time to do it, and the seasonal cost premium is smaller. The heavy winter costs, the hoarding and ground heaters and constant monitoring, mostly apply to exposed exterior work. So the answer to “should I wait for spring” partly depends on whether your pour is outdoors in the weather or indoors out of it.

A word for the DIY crowd

If you’re a capable homeowner who’d happily pour a small pad in July, I’d still gently steer you away from doing it yourself in a Calgary winter. Cold-weather concreting is where DIY jobs go wrong most often, because the margin for error is thin and the failure is total, a frozen slab isn’t weak, it’s ruined. The heated mix, the accelerator selection, the ground thawing, the blanket and hoarding management, the staged cool-down, and the temperature monitoring add up to a job that’s genuinely hard to get right without the gear and the experience. Summer is the season to experiment. Winter is the season to hire it out.

The one thing not to do

Whatever you do, don’t let anyone pour a slab in the cold without the precautions to keep it from freezing, on the theory that it’ll be fine. That’s the failure I get called to look at every spring: concrete poured on a cold day with no protection, that froze in its first night, and spent the winter looking finished while being fundamentally weak. It scales, dusts, and crumbles once the weather turns, and it has to come out and be redone. The money saved skipping blankets and heat is nothing next to the cost of pouring the same slab twice.

How to hire for a winter pour

If your project genuinely can’t wait, the contractor you choose matters even more than usual, because winter is where cutting corners does the most damage. When you’re getting quotes for cold-weather work, ask specifically how they’ll protect the pour. A crew that does this properly will talk easily about heated mix, the accelerator they use and why, how they’ll thaw the ground, what protection stays on and for how long, and how they monitor the concrete’s temperature as it cures. That fluency is the tell. Winter concreting is a discipline, and the people who do it well can describe their process without hesitating.

Be wary of a winter quote that matches a summer price. It shouldn’t, because the extra materials, heating, and labour are real costs. A suspiciously cheap winter quote usually means the protection is what’s getting skipped, and a frozen slab is the most expensive kind of savings, since it has to be torn out and poured again. Pay for the process or wait for spring. Those are the two good options. Pouring cheap in the cold and hoping is not one of them.

Common questions

Can you pour concrete in winter in Calgary? Yes. Concrete is poured through Calgary winters every year, but only with cold-weather methods: a heated mix, insulated blankets, ground thawing, hoarding and heaters for colder jobs, and a staged cool-down.

What temperature is too cold to pour concrete? Precautions become necessary once the average daily temperature drops below about 5 degrees Celsius. There’s no hard cutoff below that, it depends on how well the crew can keep the concrete warm and unfrozen while it gains strength.

What happens if fresh concrete freezes? If it freezes before reaching about 3.5 MPa, the expanding ice damages it internally and it can lose much of its final strength permanently. There’s no repair; it has to be removed and redone.

Winter concreting is a legitimate, well-understood practice. It just has to be done by someone who respects the rules and prices the job to follow them. If you have work that genuinely can’t wait for spring, look for a Calgary concrete contractor experienced with winter pours who can walk you through exactly how they’ll keep your concrete from freezing, what the protection plan is, and how long it stays in place. If they’re vague about that, wait for warmer weather.
